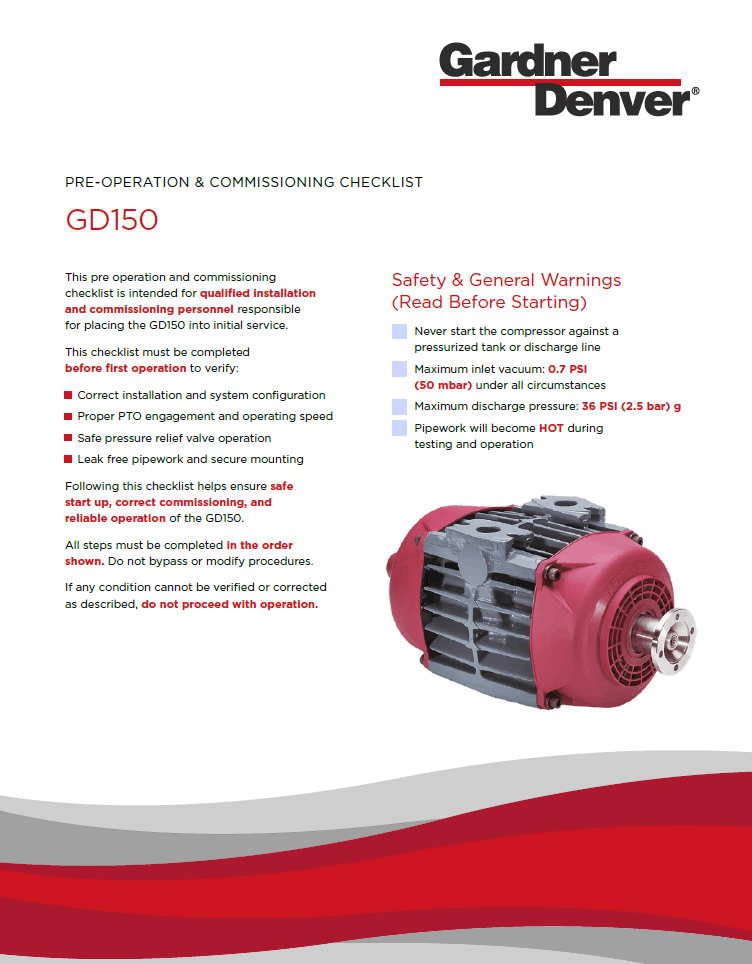

The Checklist

The Gardner Denver GD150 Pre-Operation & Commissioning Checklist provides qualified installation and commissioning personnel with a structured process for checking a newly installed GD150 before first operation.

The complete process from verifying the installation and preparing the system through initial operation, pressure testing, relief valve verification and final shutdown.

Rather than discovering an installation or system issue after the truck enters service, the checklist gives technicians a defined opportunity to identify and address potential problems during commissioning.

GD150 Commissioning Checklist

Why Proper GD150 Commissioning Matters

A compressor does not operate independently of the system around it.

The PTO, engine controls, inlet and discharge piping, valves, silencer, pressure protection and mounting all have to work together once the GD150 begins operating.

That means a successful installation isn’t confirmed simply because the compressor starts.

The commissioning process helps qualified personnel answer more important questions:

  • Is the compressor operating within its specified speed range?
  • Is the inlet free from excessive restriction?
  • Is the pipework leak-free under pressure?
  • Is the relief valve operating at the correct pressure?
  • Did the installation remain secure throughout the test?

Verifying these conditions before regular operation can help identify problems while the truck is still in a controlled commissioning environment.

Product Photo Gd150 and gd175 V1

How to Prepare a GD150 for Commissioning

Before engaging the PTO, the installation should be inspected and prepared according to the checklist.

This includes confirming that flexible and welded pipe bores are clean following fabrication, flanges and fasteners are secure, mounting points are tight and ancillary equipment has been installed in the correct sequence.

Verification that the PTO is disengaged before startup and that the engine management system has been configured for the application.

The commissioning system should include the specified 1.5 to 2 inch gate valve, silencer and 0 to 43.5 PSI (0 to 3 bar g) discharge pressure gauge.

One particularly important startup requirement is that the GD150 should never be started against a pressurized tank or discharge line.

Know the Operating Limits Before You Start

Qualified personnel should know the GD150’s operating limits before beginning the commissioning test.

Commissioning Requirement

GD150

Compressor input speed

1,000 to 1,600 RPM

Maximum inlet vacuum

0.7 PSI / 50 mbar

Maximum discharge pressure

36 PSI / 2.5 bar g

Total commissioning test duration

30 minutes



Pipework can also become hot during testing and operation, so the safety precautions identified in the checklist should be followed throughout commissioning.

How to Check the GD150 Under Operating Conditions

Once the initial installation checks have been completed, the compressor can be operated within the specified 1,000 to 1,600 RPM input speed range.

The inlet blockage indicator should be checked before increasing system pressure. If the indicator is red, the checklist directs personnel to investigate a blocked inlet filter or restriction in the inlet pipework.

Pipework should then be inspected for air leaks.

For pressure testing, the gate valve is gradually closed until discharge pressure reaches 3 PSI (0.2 bar) below the relief valve’s full-bypass setting.

The system is inspected again for leakage and the compressor is operated for a total test duration of 30 minutes.

This is why commissioning is valuable. The technician isn’t simply confirming that the GD150 can produce air. The procedure tests how the compressor and its supporting installation perform together under operating pressure.

How to Verify the GD150 Pressure Relief Valve

The pressure relief valve is another critical part of the commissioning process.

The checklist provides specific acceptance criteria:

Relief Valve Check

Requirement

Begins to crack

Within 10% below set pressure

Slight leakage

Permitted up to 7 PSI / 0.5 bar below set pressure

Full bypass

Within 5% of set pressure

Reseats

Before reaching 7 PSI / 0.5 bar below full-bypass pressure



If the valve does not operate as specified, commissioning should not simply continue.

Personnel should stop commissioning if a required step cannot be completed or abnormal operation occurs. The unit should not be placed into service until the condition has been addressed with Gardner Denver Technical Support or an authorized Gardner Denver service provider.

What Does the GD150 Checklist Cover?

The downloadable checklist provides a field reference for qualified personnel completing the initial GD150 commissioning process, including:

  • Pre-operation installation checks
  • PTO and engine management verification
  • Inlet and discharge system preparation
  • Operating speed and pressure limits
  • Inlet restriction checks
  • Pipework leak inspection
  • 30-minute commissioning test
  • Pressure relief valve testing
  • Final fastener and flange inspection
  • Proper shutdown and removal of commissioning equipment

Once the procedure has been successfully completed, the checklist also guides personnel through reducing the engine to idle, disengaging the PTO, stopping the engine, removing the test apparatus and preparing the installation following commissioning.

Country

Your request will be forwarded to the relevant individuals to assist with your request.
By clicking 'Send' you are authorizing Gardner Denver to contact you so that we may fulfill your request, as well as to communicate with you regarding our products and services.
Terms and Conditions
Privacy Policy

(* required fields)

This site is protected by reCAPTCHA.

Frequently Asked Questions About GD150 Commissioning

GD150 commissioning begins with verifying the installation, pipework, mounting, PTO and supporting components before operating the compressor. The commissioning procedure then checks operating speed, inlet restriction, system leaks, discharge pressure and pressure relief valve operation. The complete test should follow the sequence provided in the Gardner Denver GD150 Pre-Operation & Commissioning Checklist.
